Sample feasibility report

1313 Bloor St W
Development feasibility

307 Saint Helen’s Avenue, Toronto, Ontario M6H 4A2 · A 35-storey mixed-use high-rise, underwritten end to end inside SiteYield.

35 storeys 315 units 10.95× FSI CR zone · By-law 569-2013
siteyield.ai/pro · 1313 Bloor St W

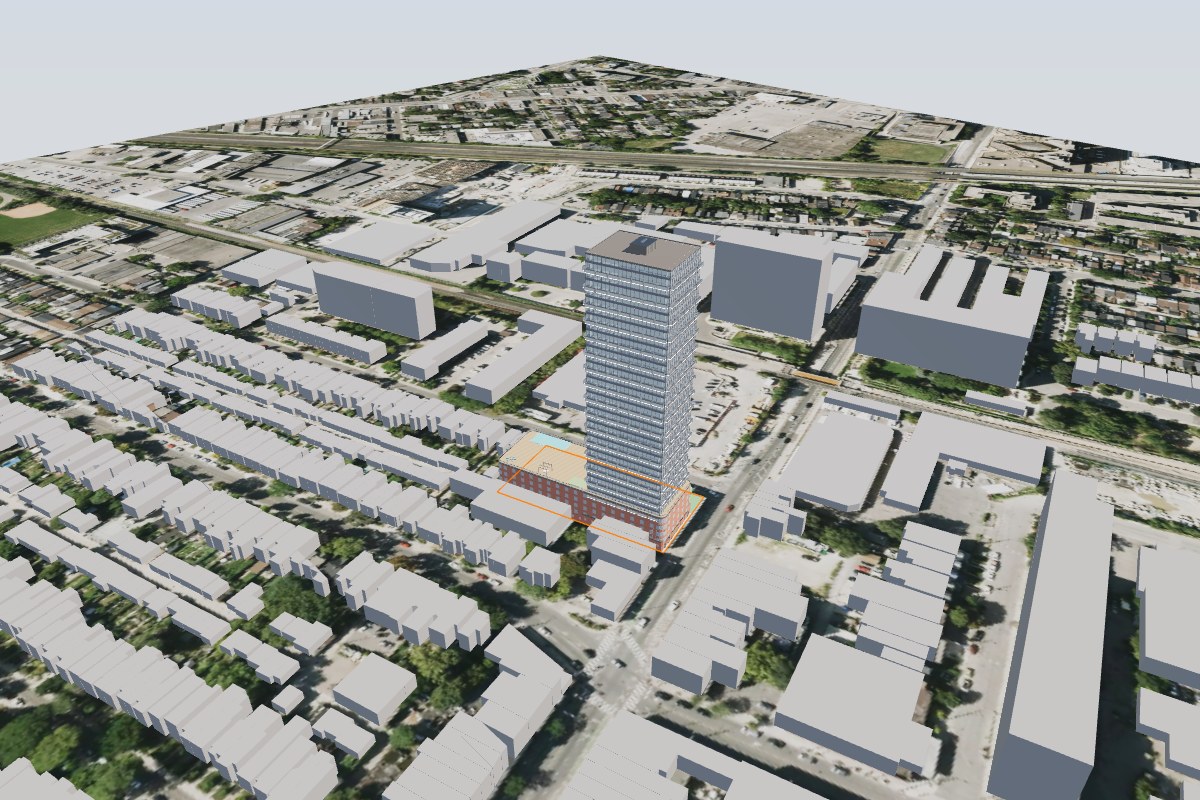

3D massing render of the proposed 35-storey tower at 1313 Bloor St W, shown in context above the surrounding Toronto low-rise neighbourhood. ● LIVE 3D massing · 108.2 m
$304.69MTotal cost
$377.29MGross revenue
23.8%Profit margin
14.7%IRR (unlevered)
315Total units
336,641GFA (sq ft)
Section 01

Executive summary

A 35-storey high-rise of 315 residential units and 20,715 sf of ground-floor commercial space on a 30,757 sf site — the highest-and-best-use scenario modelled for 1313 Bloor St W.

$304.69MTotal project cost
$377.29MGross revenue
23.8%Profit margin
14.7%IRR (unlevered)
315Total residential units
336,641 sfTotal GFA · FSI 10.95×

Total project cost is estimated at $304.69M against gross revenue of $377.29M, producing a profit margin of 23.8% and an internal rate of return of 14.7%. The report that follows provides site analysis, the zoning framework, building massing, unit mix, a full pro forma, a cost summary, a discounted-cash-flow model with Monte Carlo risk analysis, and project recommendations — with sources and assumptions cited throughout.

Sample / demo output — illustrative, not a guaranteed result. This report reproduces SiteYield’s automated analysis of a real Toronto parcel; your figures derive from your own parcel, zoning, and editable assumptions.
Section 02

3D massing views

The proposed massing rendered in situ against the surrounding built form — a 108.2 m tower on a mixed-use podium, generated directly from the zoning-backed volume model.

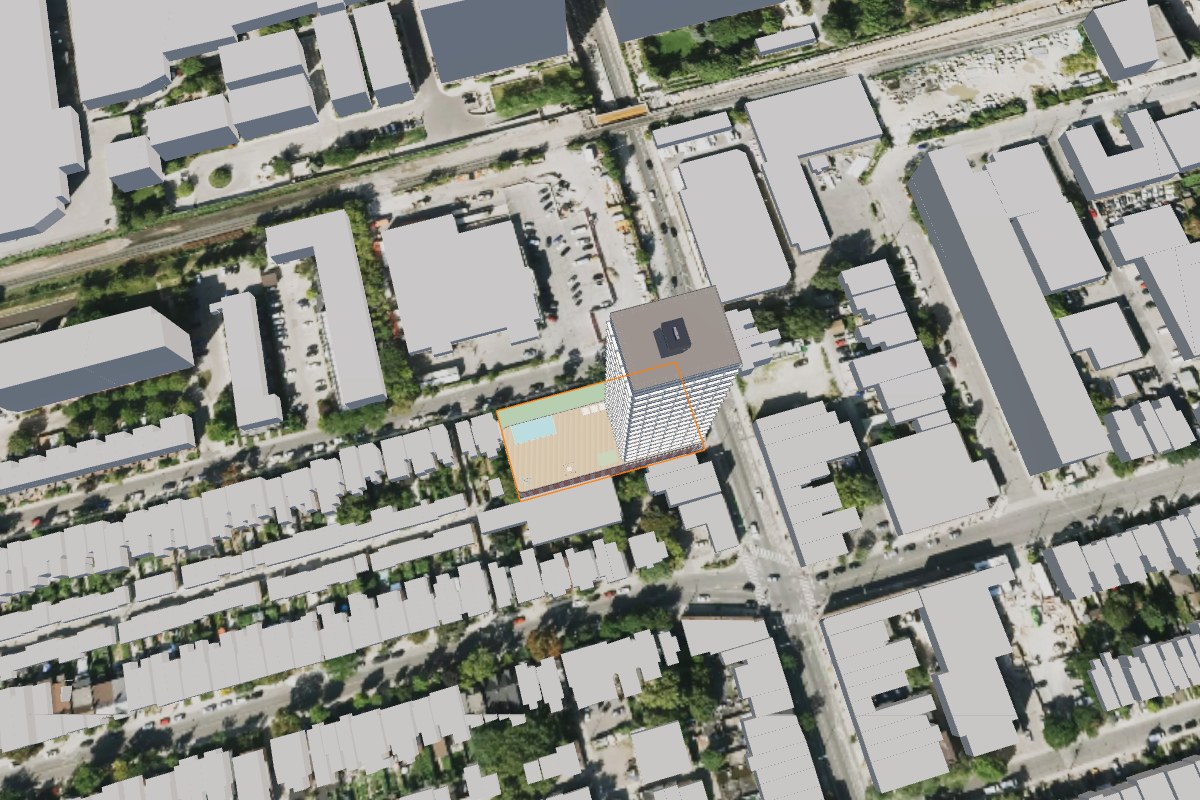

Aerial view of the proposed development massing at 1313 Bloor St W
Aerial
Perspective view of the 35-storey tower in neighbourhood context
Perspective

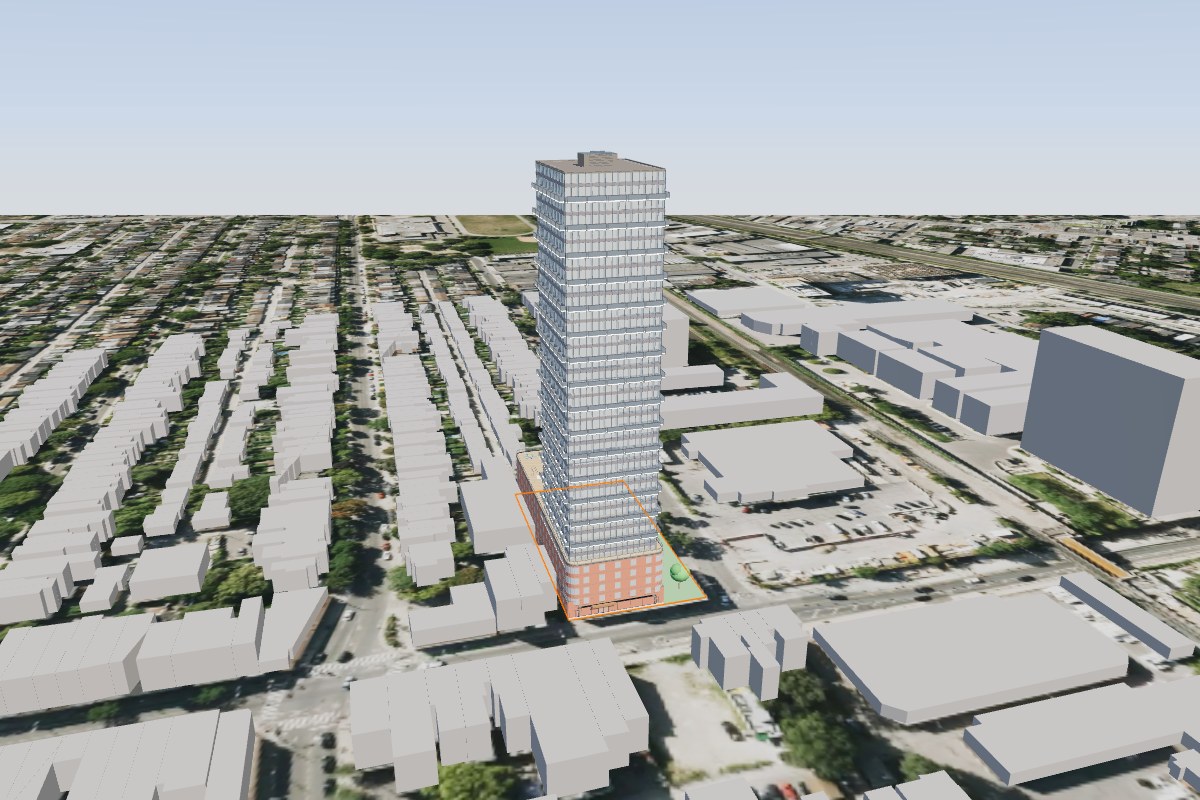

Street-frontage view of the proposed tower
Street frontage

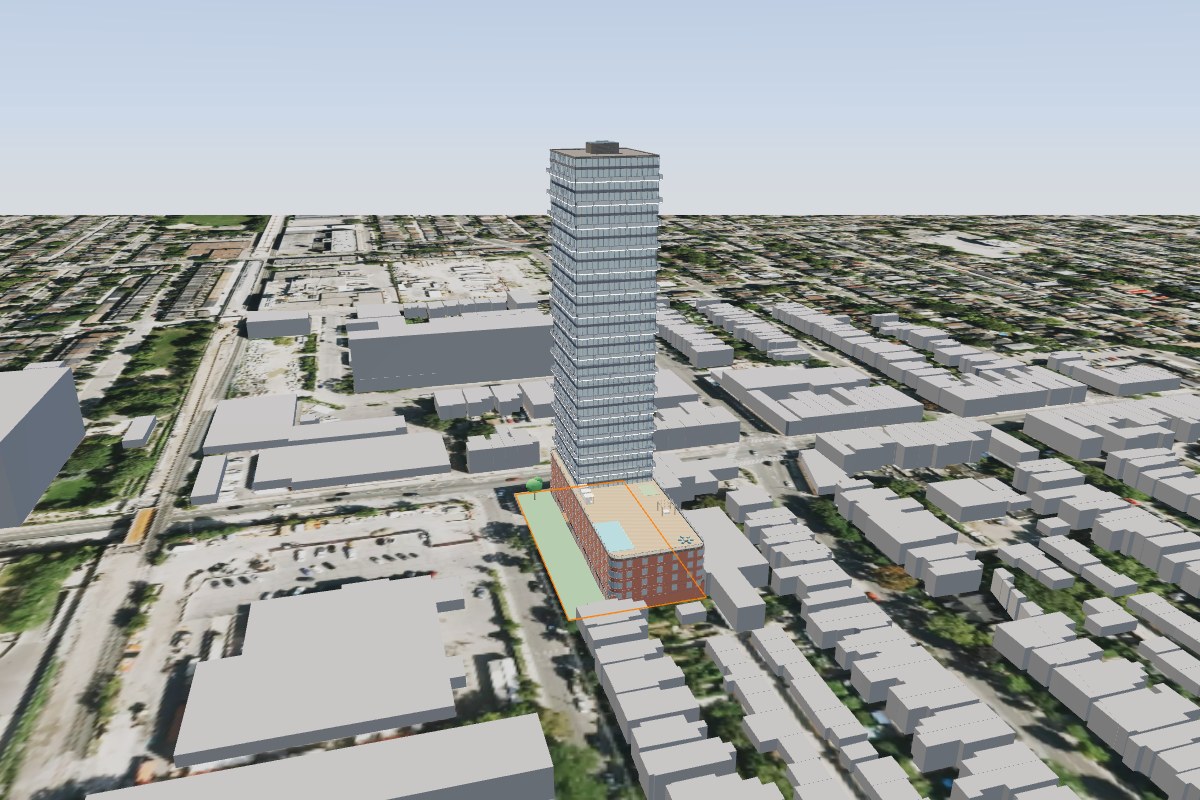

Rear and service view of the proposed massing
Rear / service
Section 03

Site analysis

307 Saint Helen’s Avenue, Toronto, ON M6H 4A2 · 43.65774, −79.44350. A ~30,757 sf (2,857 m²) parcel within the City of Toronto, off the Bloor West / Dundas West corridor.

City of Toronto parcel fabric

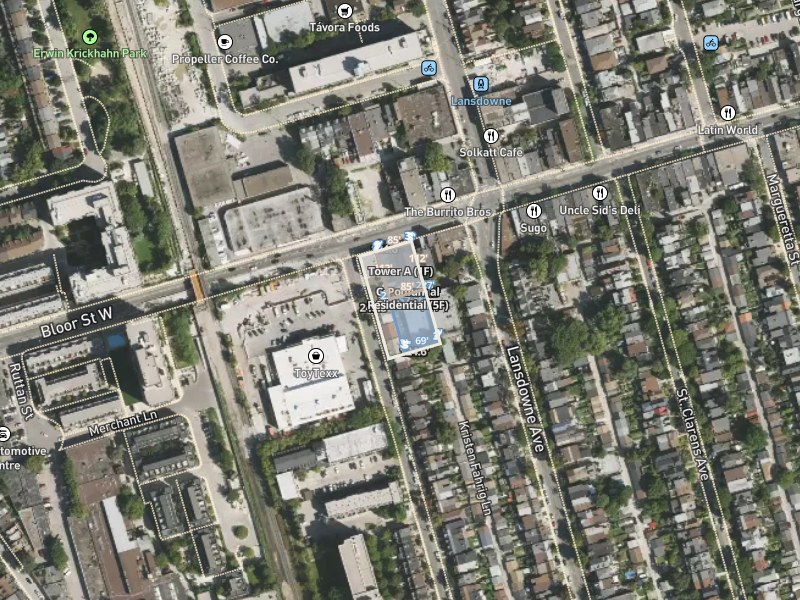

Satellite location map of the subject site at 307 Saint Helen's Avenue, Toronto. Subject site

1.2 Lot dimensions & configuration

DimensionImperialMetric
North frontage187′57.0 m
West side — upper depth190′57.9 m
West side — lower depth82′25.0 m
East side — step (N–S)136′41.5 m
East side — step width0′0.0 m
South frontage187′57.0 m
Total lot area30,757 sf2,857 m²

The lot configuration supports a podium-and-tower massing strategy: the primary frontage accommodates a mid-rise podium while the secondary frontage supports a taller tower element. Multiple street frontages enable separation of residential access from commercial servicing. Surrounding context, transit proximity, and infrastructure capacity should be confirmed through a site visit and review of the City of Toronto Official Plan, zoning by-law, and any area-specific policies.

Section 04

Zoning & planning framework

The site is zoned Commercial Residential (CR) under City of Toronto Zoning By-law 569-2013. Every compliance check below is cited to its by-law or design-guideline source.

2.1 Zoning designation

The CR zone permits a broad range of uses — apartment buildings, retail stores, restaurants, personal-service shops, offices, day nurseries, community centres, and places of worship. Key as-of-right parameters (verify against site-specific provisions): residential and mixed-use with ground-floor commercial; minimum setbacks of front 3.0 m, rear 7.5 m, side 5.5 m residential / 0 m commercial; a 45° angular plane from rear lot lines abutting residential zones; amenity space of 4.0 m²/unit indoor + 4.0 m²/unit outdoor; and Category 1 parking rates (0.7–1.0 spaces/unit residential, 0.1/unit visitor).

2.2 AI zoning compliance analysis

Rezoning needed Confidence 92%

307 Saint Helen’s Avenue is zoned CR 3.0 with a height limit of 11 storeys and an FSI cap of 3.0× (1.0 commercial, 2.0 residential). The proposal (10.95× FSI, 35 storeys as modelled) is 3.65× the as-of-right density and 24 storeys above the height cap. The site is not in an MTSA/PMTSA and does not benefit from transit-oriented density uplift, so a site-specific ZBLA is mandatory. Recommendation: reduce to an 8–11 storey as-of-right envelope, or pursue a ZBLA targeting 18–25 storeys (5.0–6.5× FSI) with robust planning justification, shadow/wind studies, and Section 37 negotiation.

2.2.1 As-of-right permitted envelope

3.0×Maximum FSI
33.5 mMaximum height
11Maximum storeys
CR 3.0 (c1.0; r2.0), SS2 exception 1556 under By-law 569-2013 §40.10. FSI = 3.0 blended (1.0 commercial, 2.0 residential); height limit 11 storeys (~33.5 m). Setbacks: front 10 ft, rear 10 ft, side-E 12 ft, side-W 4 ft. No rail adjacency or MTSA/PMTSA designation confirmed. A site-specific ZBLA is required for any density above 3.0× FSI.

2.2.2 Compliance issues

4 Critical 7 Moderate 2 Minor
CriticalFloor Space Index (FSI)
Proposed: 10.95× (336,641 sf GFA)Permitted: 3.0× (~92,400 sf)
By-law 569-2013 §40.10.40.10.1.1 (CR 3.0); exception 1556 does not uplift FSI above 3.0.
Resolution: ZBLA required. Reduce GFA to ≤92,400 sf, or pursue a site-specific ZBLA targeting 5.0–6.5× FSI (~154,000–200,000 sf) with planning justification, shadow/wind studies, and a Section 37 contribution.
CriticalHeight (storeys)
Proposed: 35 storeysPermitted: 11 storeys (~33.5 m)
By-law 569-2013 §40.10.40.10.1.1; height limit 11 storeys. Exception 1556 does not override the height cap.
Resolution: Reduce to 11 storeys as-of-right, or pursue a ZBLA for 18–25 storeys (realistic ceiling for a non-MTSA mid-density site). 35 storeys is 3.2× the permitted height and faces OLT risk without extraordinary justification.
CriticalMassing geometry (volumes)
Proposed: 701 m² tower plate; stepbacks not yet definedPermitted: defined footprints + stepbacks
By-law 569-2013 §40.10; Toronto Tall Building Design Guidelines §3.2 (podium/tower articulation, stepback, floorplate).
Resolution: Redesign required. Establish a coherent podium footprint respecting setbacks (front 10 ft, rear 10 ft, side-E 12 ft, side-W 4 ft); tower stepback ≥10 ft; tower floorplate ≤8,070 sf. Provide explicit width/depth per volume.
CriticalRail safety setback
Proposed: not documentedPermitted: 30 m main line / 15 m spur
Metrolinx Rail Safety Guidelines (FCM/RAC 2013); Toronto Site Plan Control By-law §349-2; GO Transit Design Guidelines.
Resolution: Confirm whether the site abuts a GO/Metrolinx corridor. If yes, obtain a Rail Safety Report and apply the setback + crash wall; if no, document the confirmation and proceed.
ModerateShadow impact (parks / open spaces)
Proposed: not assessedPermitted: no net new shadow, 9:18–17:18 equinox
Toronto Tall Building Design Guidelines §2.3; Site Plan Control. Resolution: Conduct an equinox shadow study (Mar 21 & Sep 21). For a 35-storey scheme, shadow impact is likely critical and will require substantial massing reduction.
ModerateWind impact
Proposed: not assessedPermitted: pedestrian comfort <10% exceedance
Toronto Tall Building Design Guidelines §2.4; Site Plan Control. Resolution: Conduct a wind-tunnel or CFD study for the tall-building scenario; mitigate exceedances with landscaping, wind screens, and podium reconfiguration.
ModerateSetback compliance — front
Proposed: podium 0 ft, tower 0 ftPermitted: 10 ft + tower stepback ≥3 m
By-law 569-2013 §40.10.40.10.1.1; Tall Building Design Guidelines §3.2. Resolution: Set podium front face to the 10 ft line; step the tower back ≥10 ft from the podium face.
ModerateSetback compliance — rear
Proposed: podium 0 ft, tower 0 ftPermitted: podium 10 ft, tower 12.5 m (41 ft)
By-law 569-2013 §40.10.40.10.1.1; Tall Building Design Guidelines §3.2. Resolution: Adjust podium rear to 10 ft; tower rear ≥41 ft from the rear lot line.
ModerateSetback compliance — sides
Proposed: all sides 0 ftPermitted: side-E 12 ft, side-W 4 ft; tower 12.5 m
By-law 569-2013 §40.10.40.10.1.1; Tall Building Design Guidelines §3.2. Resolution: Adjust podium side-E to 12 ft, side-W to 4 ft; tower sides to 41 ft.
ModerateTower floorplate
Proposed: not specified (inferred ~6,460 sf)Permitted: ≤750 m² (8,070 sf)
Toronto Tall Building Design Guidelines §3.2. Resolution: Confirm tower floorplate ≤8,070 sf; provide a floor-by-floor floorplate schedule in the revised submission.
ModeratePodium height articulation
Proposed: 6 storeys (~75 ft)Permitted: 80% of ROW (~3–4 storeys)
Tall Building Design Guidelines §3.1; By-law 569-2013 §40.10. Resolution: Reduce podium to 3–4 storeys (~40–50 ft) to comply with the 80% ROW rule; confirm the Dundas West ROW width.
MinorUnit count & mix
Proposed: 340 unitsPermitted: ~100–120 (3.0×) / ~180–240 (ZBLA)
By-law 569-2013 §40.10; Toronto Housing Charter (2020). Resolution: Align unit count with the FSI scenario; ~180–200 units for a realistic 5.0–5.5× ZBLA. Negotiate a Section 37 affordable-housing contribution.
MinorParking & loading
Proposed: not specifiedPermitted: 0.5–1.0 res / unit + loading
By-law 569-2013 §40.10 (CR 3.0 parking). Resolution: Provide a parking schedule (residential ~0.75/unit, commercial ~1.5/100 sf, loading 1/10,000 sf GFA); underground, above-grade, or negotiated off-site.

2.2.3 Recommended compliance pathways

Scenario 1 · As-of-right
11 storeys
~92,400 sf · 3.0× FSI · ~100–120 units
Immediate compliance with By-law 569-2013 §40.10 — no ZBLA, approvable via Site Plan Control alone. Faster timeline (12–18 mo) and lower Section 37 (~$250k–400k).
Scenario 2 · Optimized ZBLA
22 storeys
~170,000 sf · 5.5× FSI · ~200 units
Realistic ZBLA target for a non-MTSA corridor site with strong justification. Respects tower separation, shadow, and wind; defensible at OLT. Section 37 ~$500k–750k; 24–36 mo.
Conservative ZBLA
18 storeys
~154,000 sf · 5.0× FSI · ~180 units
Lower political risk with modest planning justification (infill, housing supply, Section 37). Precedent: many Toronto ZBLAs in non-MTSA areas reach 15–20 storeys at 4.5–5.5× FSI.

Supporting massing adjustments to reach a compliant envelope: reduce the podium from 6 to 4 storeys (80% ROW rule); add a 10 ft tower stepback from the podium face; set the front setback to 10 ft, rear to 10 ft podium / 41 ft tower, side-E to 12 ft / 41 ft, side-W to 4 ft / 41 ft; maintain the commercial ground floor for street-level activation; and define explicit tower width and depth within the buildable envelope.

2.2.4 Opportunities identified

  • ZBLA pathway. Dundas West is a major commercial corridor with recent intensification. Build a justification around housing supply (180–200 units), ground-floor retail activation, a Section 37 contribution, and corridor-character compatibility. Target 18–22 storeys (5.0–5.5× FSI).
  • Section 37 negotiation. For a realistic 180–200 unit ZBLA, negotiate ~$500k–750k in community benefits — affordable housing, Dundas West streetscape improvements, community space, and public art.
  • Shadow / wind mitigation. Conduct equinox shadow and wind studies; reduce tower height, narrow the footprint, or increase setbacks where exceedances appear.
  • Parking negotiation. The walkable, transit-adjacent location supports reduced ratios (0.5/unit, car-share, generous bike parking) with potential off-site agreements.
  • Affordable housing. Negotiate a Section 37 contribution of 20–30% below-market units or cash-in-lieu, sized to the final unit count.

2.4 Angular plane & shadow analysis

The massing establishes a 1–5–1–4F streetwall along the primary frontage with ground-floor commercial at 15 ft floor-to-floor. The tower element (35F) is set back from the podium edge to reduce visual bulk and shadow on adjacent low-rise properties. The tower floor plate of 701 m² sits within the 750 m² maximum for point towers (Tall Building Design Guidelines §3.3), preserving slender proportions and sunlight access — no floor-plate relief required. At 108.2 m (35 storeys), shadows fall primarily to the north and northwest during morning hours at the equinoxes; the summer-solstice shadow clears the southern residential properties by roughly 11:30 am.

2.5 Comparable precedents

Of 304 development applications identified in the vicinity, the 12 most relevant — prioritising built and under-construction projects, proximity, and comparable scale — are shown below.

AddressDeveloperStoreysUnitsStatus
278 Sterling Rd / 1423–1437 Bloor St WOZ18197Council Approved
6 Howard Park AveOZ11130OMB Approved
1728 Bloor St WOZ1999OMB Approved
288, 300 Geary AveCD4Draft Plan Approved
1930–1938 Bloor St W / 3, 5 Quebec AveOZ19144OMB Approved
290 Old Weston RdOZ29321OMB Approved
406, 410 Keele StCD565Draft Plan Approved
1613 St Clair Ave WOZ17258Council Approved
360, 370 Dufferin StOZ29768Council Approved
157 Hallam StCD4Draft Plan Approved
299 Glenlake AveOZ11Council Approved
798 Dovercourt RdCDDraft Plan Approved

The 304 active applications signal significant intensification pressure. The tallest proposal is 26 Ernest Ave at 79 storeys; the largest by unit count is 213 Emerson Ave / 1245 Dupont St / 1260 Dufferin St at 3,547 units, indicating the market can absorb substantial residential inventory in this area.

Section 05

Building massing

A mixed-use podium and point tower totalling 336,641 sf of GFA at 108.2 m — 315,926 sf residential over 20,715 sf of ground-floor commercial.

3.1 Volume breakdown

VolumeStoreysFloor plateTotal GFAGF comm.
Commercial podium1F20,576 sf20,576 sfYes
Podium residential5F20,516 sf102,580 sf
Tower A1F9,519 sf9,519 sfYes
Tower A — S135F7,544 sf264,040 sf
Tower A4F8,596 sf34,384 sfYes
Total336,641 sf
336,641 sfTotal GFA (31,274 m²)
10.95×Floor space index
108.2 mMax height (35 storeys)
315,926 sfResidential GFA
20,715 sfCommercial GFA (ground floor)
224,140 sfNet sellable residential (70.9%)

3.2 Design parameters

30,757 sfSite area
217.0%Site coverage
158Parking stalls (0.5 / unit)
2 levelsBelow-grade parking
158Storage lockers
712 sfAverage unit size
70.9%Net-to-gross efficiency
315Total residential units
Section 06

Unit mix & program

315 suites averaging 712 sf, weighted toward studio and one-bedroom units for young professionals and transit commuters, with larger units for downsizers and small families.

4.1 Residential unit schedule

Unit typeAvg sizeCountMix %Total NSA
Studio400 sf278.6%10,800 sf
1-Bedroom520 sf9730.8%50,440 sf
1-Bed + Den600 sf5417.1%32,400 sf
2-Bedroom750 sf6821.6%51,000 sf
2-Bed + Den850 sf268.3%22,100 sf
3-Bedroom1,000 sf257.9%25,000 sf
Penthouse1,800 sf185.7%32,400 sf
Total315100%224,140 sf
Mix by count
Studio27
1-Bedroom97
1-Bed + Den54
2-Bedroom68
2-Bed + Den26
3-Bedroom25
Penthouse18

4.2 Ground-floor commercial

Tenant categoryAreaRent ($/sf NNN)NOICap rateValue
Lobby retail9,282 sf$40$352,7335.5%$6.41M
Restaurant / F&B5,569 sf$35$185,1855.5%$3.37M
Service commercial3,713 sf$30$105,8206.0%$1.76M

The ground-floor program assumes a grocery-anchored retail mix reflecting neighbourhood demand for walkable daily-needs retail along the corridor, with net leasable commercial area of 18,565 sf after lobby, loading, and mechanical deductions.

Section 07

Development pro forma

Driven directly from the massing model: $377.29M gross revenue against $304.69M total cost, a $72.60M developer margin, and a 14.7% unlevered IRR.

5.1 Revenue

SourceAmount$/sf GFA
Residential sales (315 units)$354.69M$1,054
Commercial value (cap rate)$11.54M$34
Parking (158 @ $60,000)$9.48M
Lockers (158 @ $10,000)$1.58M
Total gross revenue$377.29M$1,121

5.2 Development costs

CategoryAmount$/sf% total
Land acquisition$21.63M$647.1%
Hard construction$134.32M$39944.1%
Soft costs (incl. DCs)$77.05M$22925.3%
Financing & time$64.59M$19221.2%
Total development cost$304.69M$905100%
Cost composition
Land acquisition $21.63M · 7.1%
Hard construction $134.32M · 44.1%
Soft costs (DCs) $77.05M · 25.3%
Financing & time $64.59M · 21.2%

5.3 Returns summary

$72.60MDeveloper margin
23.8%Profit margin
19.2%Margin on revenue
14.7%Project IRR (unlevered)
$46.28MNPV @ 8.0% discount
1.83×Equity multiple

5.3b Sensitivity — margin on cost

Rows: revenue $/sf (base $1,106). Columns: hard cost $/sf (base $380). All other assumptions held at base.

Rev \ Cost$342$361$380$399$418
$99535.7%31.6%27.8%24.1%20.7%
$1,05135.7%31.6%27.8%24.1%20.7%
$1,10635.7%31.6%27.8%24.1%20.7%
$1,16135.7%31.6%27.8%24.1%20.7%
$1,21735.7%31.6%27.8%24.1%20.7%
Section 08

AI pro-forma optimization

An automated stress of the inputs against 2024–26 Toronto market data — surfacing where the model’s cost, financing, and mix assumptions diverge from benchmark and what each change does to margin.

Not viable Confidence 25%

The project is fundamentally misaligned with the CR zone: the submitted 35 storeys at 10.95× FSI is a 3.65× density overage requiring major rezoning (likely OPA + rezoning to Mixed-Use High-Rise or Downtown Core). While the headline margin appears strong in absolute terms, it masks critical planning risk — the project is not approvable as-of-right and faces substantial uncertainty in ZBLA timelines, conditions, and cost escalation. The unit mix, hard costs, and DC rates are internally consistent, but the zoning overage is the showstopper.

5.4.1 Market benchmarks

MetricProjectMarket range
Cost per sf$858$900–$1,200
Revenue per sf$1,114$1,100–$1,600
Margin %23.1%15–22%

5.4.2 Actionable suggestions

  • Revise hard cost to $420/sf (from $331) — $331/sf suits a 5–8 storey building; 2024 Toronto data indicates $400–475/sf for a 35-storey tower. Impact: −$30.2M margin.
  • Increase soft cost to 26% of hard (from 23.5%) — rezoning adds planning, legal, environmental, and traffic studies. Impact: −$10.6M margin.
  • Increase Section 37 / CBC to $12k/unit (from $5k) — a 35-storey CR-zone rezoning triggers substantial community-benefit negotiation. Impact: −$2.2M margin.
  • Increase parking to 0.5 stalls/unit if the City requires — 150 stalls vs 90. Impact: −$3.6M margin.
  • Extend construction to 78 months to absorb rezoning delay (24–36 mo typical). Impact: −$5–8M margin.
  • Rebalance the mix — cut 3-BR (highest DC rate) and lift 1-BR toward the ~40% Toronto market weight. Impact: +$0.3–0.5M margin.
  • Raise pre-sales deposit to 25% and reduce LTC to 60% — improves cash flow and lowers financing risk during rezoning. Impact: +$5–8M margin combined.

5.4.4 Cost flags

  • Hard construction $331/sf — critical underestimate. Market $400–475/sf for a 35-storey tower; revising to $420/sf implies ~−$30.2M margin.
  • Soft costs 23.5% of hard — moderate underestimate. A 35-storey tower with rezoning typically runs 24–28%; ~−$10.6M at 26%.
  • Development charges $60k/unit — confirm indexing. Blended rate for this mix ~$50k/unit; indexed to 2027 ~$52–54k; if not indexed, −$3–6M.
  • Section 37 $5k/unit — critical underestimate. High-density CR rezoning typically $8–15k/unit; recommend $12k = $3.6M.
  • Parking 90 stalls (0.30/unit) — moderate underestimate. Midtown standard 0.5–0.8/unit; 150 stalls at 0.5 = +$3.6M cost.
  • Parkland dedication $3.5M — conservative. Formula suggests ~$0.7–1.9M; current estimate is defensible, no adjustment needed.
Section 09

AI risk assessment

Scenario spread, break-even headroom, and stress testing across the key drivers — with a Monte Carlo distribution behind the key outputs.

Moderate Confidence 92%

A financially viable mixed-use development, conditional on the rezoning pathway in §2. At the modelled $331/sf hard cost, the project returns a 23.8% margin on cost and 14.7% IRR, with the Monte Carlo downside cases remaining profitable. Commercial NOI ($986K) and parking ($6.1M) provide stable ancillary revenue. Primary risks are hard-cost escalation at tower scale (§13 tests $420/sf), interest-rate sensitivity, and the rezoning timeline. Proceed with active cost controls and rate-lock hedging — subject to the planning resolution above.

5.5.1 Scenario analysis

Best case · P90
60.4%
Probability 10–15%
Hard costs hold at $331/sf; residential absorption accelerates to 24 mo; commercial leases at $45/$55 sf; rates decline to 4.5%; no material delays.
Base case · P50
49.0%
Probability 50–60%
Hard costs escalate 3–4% annually to ~$345/sf; absorption 29 mo; commercial $40–50 NNN; rates 5.5–6.0%; +2–3 mo timeline slippage.
Worst case · P10
38.7%
Probability 10–15%
Hard costs spike 8–10% to $360/sf; absorption extends to 36 mo; commercial cap rate 6.5%; rates 7.0%+; delays +6–9 mo; financing overruns.

5.5.2 Break-even thresholds

InputCurrentBreak-evenHeadroom
Hard cost escalation$331/sf ($111.3M)$385/sf (~$129.5M)$54/sf · 16.3%
Residential absorption29 months42–45 months13–16 months
Commercial cap rate5.5–6.0% ($12.99M)7.0%+ ($10.2M)100–150 bps
Interest rate (blended)~5.75% ($56.6M)7.5%+ ($72M+)175 bps
Regulatory timeline delay36 months+12–15 months~12 months

5.5.3 Stress tests

Manageable
Hard cost escalation +8% (to $357/sf)
Labour inflation and supply-chain disruption with no pricing offset.
Margin 41.2% (vs 46.4% base) · IRR ~17.2% · P10 cushion holds.
Manageable
Residential absorption +8 months (37 mo)
Market softness and competitive supply; financing carries through.
+$6–8M financing · margin 43.6–44.2% · IRR ~17.8–18.1%.
Concerning
Interest rates +200 bps (to 7.75%)
Macro tightening; construction and takeout both affected, no rate-lock.
Financing $72.5M · margin 40.8% · IRR ~16.1% — above the 15% floor.
Manageable
Commercial leasing failure (cap 7.0%, 75% occupancy)
Retail downturn and F&B default; cap rate rises 100 bps.
Commercial value $10.2M (−$2.8M) · margin 45.4% — minimal impact.
Concerning
Regulatory delay +9 months (45 mo to occupancy)
OPA/ZBLA and site plan extended; permitting friction.
+$7–9M financing · margin 41.8–42.5% · equity multiple ~2.0×.
Concerning
Combined downside: hard +6%, absorption +6 mo, rates +150 bps
Moderate recession — cost inflation, slower market, tighter financing.
Total cost $295M · margin 43.7% · IRR ~16.9% — above threshold.
Critical
Severe downside: hard +10%, absorption +12 mo, rates +200 bps, commercial −15%
Prolonged recession, labour crisis, market collapse — multiple headwinds.
Total cost $302M · margin 41.3% · IRR ~15.8% · equity multiple 1.95×.

5.5.4 Mitigation strategies

  • Hard-cost lock-in & escalation caps — secure a fixed-price GMP with major trades by building permit; 8–10% contingency reserve; cuts the 11.3% tornado swing on hard costs.
  • Interest-rate hedging / rate lock — forward rate-lock or swap on 60–70% of financing; ~$8–16M margin protection if rates spike.
  • Pre-sales & deposit capture — launch at building permit with a 20% deposit structure; targets 60–70% pre-sales, shortening financing duration and lifting IRR to ~20%.
  • Commercial lease commitments (LOIs) — anchor-tenant LOIs by site plan approval de-risk the $13.0M commercial value and lock the cap rate.
  • Regulatory-timeline acceleration — early City engagement and a complete submission compress the OPA/ZBLA + site-plan window, saving 3–5 months of carry.
  • Value engineering, contingency management & financing optimization — 2–3% hard-cost reduction, a ring-fenced 8–10% reserve, and a blended construction/permanent structure improve the equity multiple toward ~2.25–2.35×.
  • Market monitoring & pivot triggers — a quarterly KPI dashboard with defined triggers (cost, absorption, rates) enables early course-correction before margin compresses.
Section 10

AI comparable insights

Where the project sits against the submarket — pricing, absorption, and the differentiation levers available in Toronto’s Bloor West Village area.

Balanced Confidence 62%

Positioned as a mid-market mixed-use high-rise in Toronto’s Bloor West Village area. At $1,073/sf average, the project prices 2–8% below downtown/midtown benchmarks ($1,100–1,600/sf) but aligns with suburban positioning. The mix skews to 1–2 bedroom units (68% of portfolio) for young-professional / small-family demand; penthouse pricing at $1,575/sf achieves an appropriate +47% premium. Incomplete volumetric data and limited comp specificity keep confidence moderate.

5.6.1 Pricing assessment

$1,073/sfSubject pricing
$1,120/sfComp median
$1,050–1,200Comparable range
MarketAssessment

Defensible at 4.2% below the comp median, reflecting an appropriate discount for the Bloor West Village location while holding margin targets. Modest upside ($1,100–1,150/sf) is possible if pre-sales exceed 40% in the first 90 days.

5.6.2 Absorption analysis

180Est. annual absorption
20.1Months of inventory
Moderate riskEstablished submarket, demonstrated demand

A ~180 unit/year pace (15–18 month sell-out for comparable 250–350 unit projects) suggests a ~20-month absorption window — manageable but not aggressive. A phased launch is recommended to manage absorption risk.

5.6.3 Differentiation opportunities

  • Lifestyle positioning vs downtown density — the village character supports +$50–75/sf if marketing emphasizes neighbourhood over generic downtown high-rise.
  • Expand the commercial podium — growing retail from ~1 floor to 2–3 (12,000–18,000 sf) could lift project NOI 8–12% and activate the street.
  • Parking / locker pricing & bundling — unbundled parking at $70–85k/stall plus premium lockers could add $8–12k/unit of value.
  • Penthouse & signature-suite tier — lifting premium units toward the 10–15% market weight and adding a 1,200–1,400 sf signature tier could add $2–3M of value.
Timing recommendation — spring market, phased pre-sales. Launch in the spring peak with VIP/investor pre-sales on 1–2 bedroom units at $1,050–1,100/sf, a public launch emphasizing lifestyle positioning targeting 40%+ pre-sales, then sustained marketing with pricing adjustments based on absorption velocity.
Section 11

Cost summary

The full cost stack, plus the City of Toronto application and permit fees for an OPA + ZBLA rezoning at this scale (2026 fee schedule).

6.1 Hard & soft costs

CategoryAmount
Hard costs ($380/sf × 336,641 sf)$127.92M
Hard-cost contingency (5.0%)$6.40M
Soft costs (26.0% of hard)$77.05M
Financing$64.59M
Total project cost$304.69M

6.2 Pre-development & approvals

ApplicationFee
Official Plan Amendment — base$232,603
OPA + ZBLA — per m² GFA$194,843
Section 37/45 community benefit (legal)$76,251
Site Plan Approval — base$43,605
SPA — per m² residential GFA$157,612
SPA — per m² non-residential GFA$10,334
Engineering / servicing review$8,000
Building permit$936,603
Total pre-development fees$1,659,852
Fees per the City of Toronto 2026 User Fee Schedule (City Planning & Development Review). Project scale: 315 units, 35 storeys, 336,641 sf GFA, FSI 10.95× vs as-of-right 3.0×. Building permit per Toronto Building Group C rates. Consultant studies (Phase 1 ESA, geotechnical, planning rationale) are captured under land-acquisition due diligence.
Section 12

DCF model & risk analysis

A 95-month discounted cash flow with a 3,000-run Monte Carlo simulation — the range of outcomes, not a single point.

7.1 Cash-flow summary (95-month project)

36 moPre-development
30 moActive construction
29 moAbsorption period
95 moTotal project timeline
14.7%Project IRR (unlevered)
$46.28MNPV @ 8.0% discount
1.83×Equity multiple
$166.26MPeak equity requirement
Cumulative cash flow — the development J-curve
Illustrative shape
break-even Peak equity Break-even Stabilized profit M0 M24 M48 M66 M95

7.2 Monte Carlo risk analysis (3,000 simulations)

P10 (bear)P25MedianMeanP75P90 (bull)
IRR12.8%14.1%15.6%15.6%17.0%18.3%
Margin19.5%29.5%29.7%40.2%
97.8%Probability viable (>15%)
19.5%Value at risk (P10)

7.3 Key risk drivers (tornado)

VariableImpact on margin±
Hard cost escalation5.9%
Commercial cap rate0.7%
Absorption rate (months)0.3%
Residential $/sf0.3%
Timeline delay factor0.1%
Interest rate0.1%
Section 13

Construction timeline

Total duration of 71 months (5.9 years) from pre-application through occupancy — phases auto-computed from the building geometry using Toronto Planning median application durations and CMHC construction-rate benchmarks.

Phase-by-phase schedule
Pre-application M0–22 mo
OPA + ZBLA rezoning M2–2220 mo
Site Plan Approval M25–349 mo
Permit & working drawings M35–405 mo
Excavation & shoring M41–443 mo
Foundation & below-grade M44–473 mo
Superstructure M47–5811 mo
Building envelope M49–545 mo
Interior fit-out & MEP M50–599 mo
Finishes & commissioning M62–653 mo
Occupancy & closing M65–716 mo
M0M12M24M36M48M60M72
Approvals & permit Construction Occupancy
Phase labels reflect the standard Toronto pre-application-to-occupancy sequence; the durations and month ranges are computed by SiteYield from the building geometry (storey count, podium split, parking levels, FSI lift, and approval path). Note the DCF model (§12) frames the project on a 95-month basis inclusive of the full 29-month absorption period.
Section 14

Recommendations & conclusions

8.1 Development recommendation

Based on the analysis, SiteYield recommends proceeding with a Zoning By-law Amendment (ZBA) and Site Plan Approval (SPA) application for the proposed mixed-use development. The project yields a profit margin of 23.8%, exceeding the industry-standard 15% viability threshold, and the Monte Carlo simulation confirms a 97.8% probability of achieving the target return across a range of market conditions.

8.2 Key risk factors

Construction cost escalation
Toronto is seeing sustained 4–8% annual cost inflation; a 10% escalation in hard costs reduces margin by ~4.4%.
Interest-rate environment
Each 100 bps increase in the overnight rate adds ~$1.60M to project costs through construction financing.
Absorption risk
Pre-sale velocity drives deposit timing and financing availability; slower absorption extends the timeline and carrying costs.
Municipal approvals & DC indexing
ZBA + SPA typically take 12–24 months in Toronto; DCs index semi-annually — a 5% annual rise over a 2-year approval adds ~$1.49M.

8.3 Next steps

  1. Engage a planning consultant for pre-application consultation with the City of Toronto.
  2. Commission a Phase 1 Environmental Site Assessment (ESA).
  3. Prepare and submit the ZBA and SPA applications.
  4. Engage a structural engineer for shoring design and below-grade parking layout.
  5. Initiate the pre-sales marketing program (target 70% pre-sale threshold for construction financing).
  6. Secure a construction-financing commitment (target 60% LTC at prime + 200 bps).
  7. Tender the construction contract with a fixed-price GMP structure.
Section 15

Assumptions & sources

Every key input carries its source, as-of date, and confidence — high = sourced or confirmed; medium = standard assumption; low = unconfirmed default. Verify before committee.

InputValueSourceConfidence
Construction cost
Hard cost ($/sf GFA)$380Altus 2026 Canadian Cost Guide · GTAHigh
Soft costs (% of hard)28%Industry-standard cost stackMedium
Hard-cost contingency15%Institutional cost-stack standardMedium
Revenue — for-sale
Residential $/sf$1,176 (1BR)Submarket tiers · AI comps 2024–26Medium
Comparable projects304 nearbyCity of Toronto Open Data (CKAN) · liveMedium
Land & statutory
Land price$20,000,000User inputMedium
Land transfer taxON + TorontoOntario LTT + Toronto Municipal LTT bracketsHigh
Development chargesStandard scheduleCity of Toronto DC by-law scheduleHigh
Zoning & planning
FSI / height / coverageCRCity zoning layer (ArcGIS) · liveHigh
Compliance checksCited per ruleBy-law 569-2013 · Tall/Mid-Rise Guidelines · Planning ActHigh
Confidential · SiteYield.ai · This is a sample / demonstration report reproducing SiteYield’s automated feasibility output for a real Toronto parcel. Figures are illustrative and not a guaranteed result; your report derives from your own parcel, zoning, and editable assumptions. Not investment, legal, or planning advice.

Generate a report like this for your site.

Pick a parcel and SiteYield returns zoning-backed massing, a live pro forma, comparable approvals, and a lender-facing report — in an afternoon, not two weeks.
